Minnesota Department of Transportation

511 Travel Info

Hwy 56 reconstruction

LeRoy

Sign up for project email updates

About this project

Summary of work

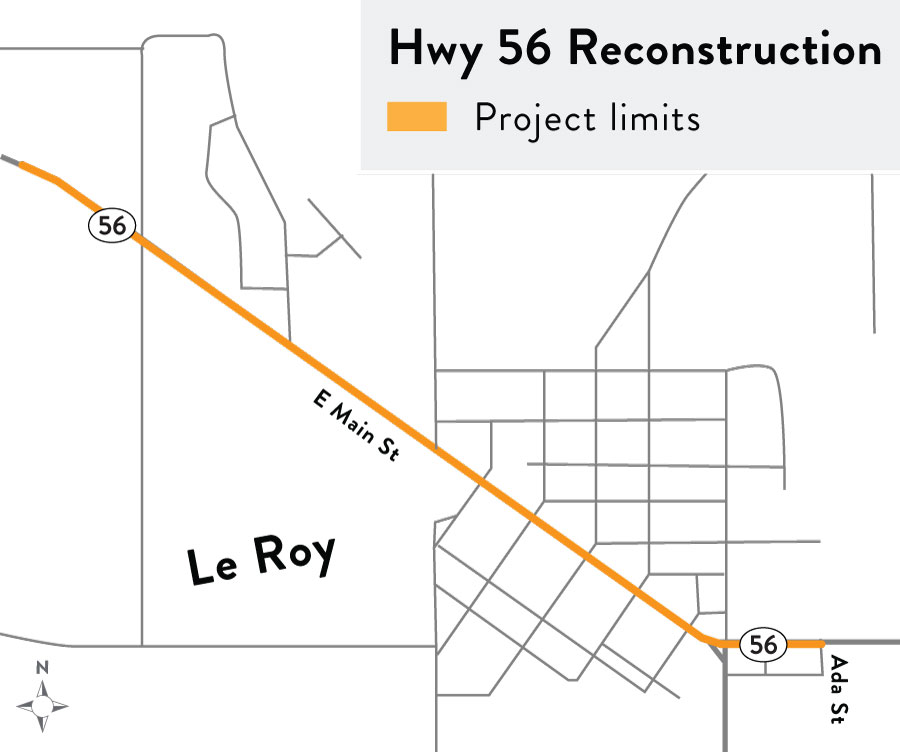

Hwy 56 Reconstruction Map
Hwy 56 Reconstruction Map (click to enlarge)

A 1.2-mile stretch of Hwy 56 will be reconstructed in LeRoy to address deteriorating pavement conditions, improve drainage, enhance student crosswalk safety and make pedestrian improvements to meet current accessibility standards. At the same time, the City of LeRoy will replace aging city utilities underneath the road.

Construction for this project will take place in three stages in 2024. Learn more in the traffic impacts section below.

Construction is scheduled to begin April 29, 2024. It anticipated to be completed in October 2024. MnDOT also plans to conduct additional landscaping work (tentatively in 2025), which will include adding new trees to boulevards.

The following is the planned work:

  • Reconfigure Mower Co. Rd. 12, Hwy 56 and Main St. E. intersection to improve safety by reducing vehicle speeds while maintaining efficient traffic flow
  • Construct a cul-de-sac west of Mower Co. Rd. 12
  • Create a buffer zone between traffic and parking from Mather St. to Everett St. for biking
  • Improve school crosswalk safety by constructing a bump out at Mower Co. Rd. 14 and creating a wider school parking zone
  • Replace aging storm water, sanitary sewer and water main utilities underneath Hwy 56
  • Extend water main past Ada St.
  • Replace and install new curb and gutter
  • Replace and install new sidewalks
  • Landscaping, such as adding trees to boulevards (likely in 2025)

Details can be viewed on the project layout map.

Traffic impacts

Hwy 56 construction sections
Hwy 56 construction sections (click to enlarge)

Below are project plans and detour routes. The timeframes are weather dependent. Construction will take place in three stages to better align with the city’s sewer reconstruction efforts.

People will be able to reach their destination within the construction zone. However, which direction they take may depend upon the day’s work.

Residents and business owners with questions about access to properties can contact Tim Heins, 507-208-3840 or Dwayne Pike, 507-206-8364.

Stage 1

Crews removed select trees along the corridor in early 2024.

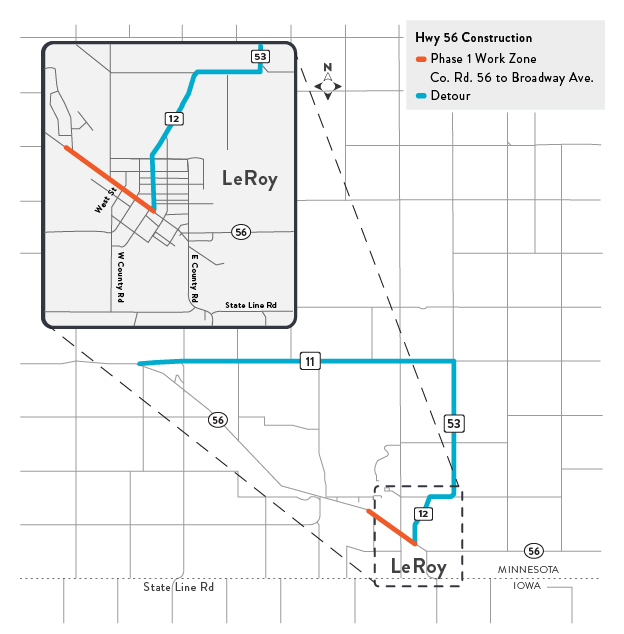

Hwy 56 stage 2a detour map
Hwy 56 stage 2a detour map (click to enlarge)

Stage 2a

April 29 to early July 2024
Crews will work between Co. Rd. 56 to S Mather St. (green zone) and Everett St. and east of Ada St. (yellow zone). Traffic will be detoured along Co. Rd. 12, 53 and 11, as well as W County Rd. and 105th St.

Crews will start on the east end and then move to the west end during Stage 2a. The full detour will be in place during this stage. Residents will be able to access their properties in the work zone.

View the town detour map and the extended detour map.

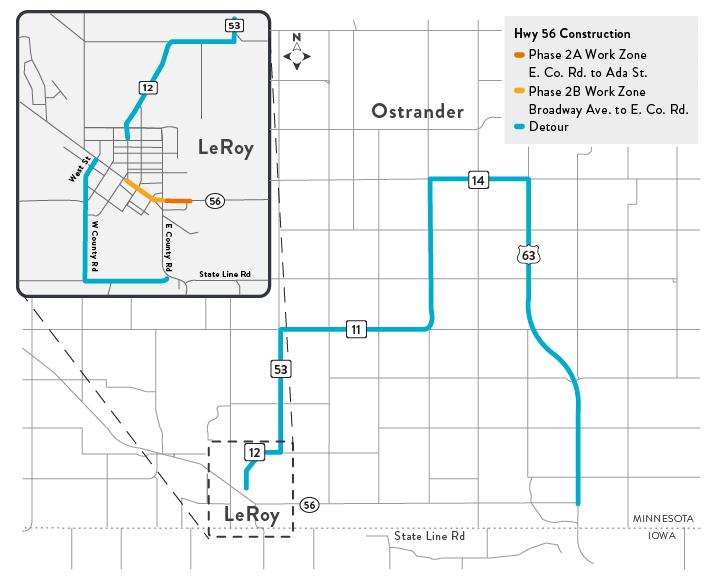

Hwy 56 stage 2b detour map
Hwy 56 stage 2b detour map (click to enlarge)

Stage 2b

Tentatively: June to mid-August 2024 (The start date of Stage 2b will depend on the progress of Stage 2a.)
Crews will work between Co. Rd. 56 to S Mather St. (green zone). Traffic will be detoured along Co. Rd. 12, 53 and 11.

View the town detour map and the extended detour map.

Hwy 56 stage 3 detour map
Hwy 56 stage 3 detour map (click to enlarge)

Stage 3

Tentatively: Late July to mid-October 2024
Once stages 2a and 2b are complete, crews will work between S Mather St. and Everett St (blue zone). Traffic will be detoured right, south of Co. Rd. 56 and N Mather St.

View the detour map.
