Washington St.—Brainerd

Hwy 210 from Baxter Dr. to Pine Shores Rd., Crow Wing County

Two-year look ahead

The Washington St. project will take two full construction seasons to complete from spring 2026 to fall 2027. Crews will finish any remaining work in spring-summer 2028.

2026 work segments:

  • East — Pine Shores Rd.to 10th Ave. NE
  • Mall — 10th Ave. E to 5th Ave. NE
  • Railyard — 5th Ave. E to near Kingwood St.

2027 work segements:

  • West — Baxter Dr. to 4th St. - resurface
  • Bridge — 4th St. NW to east of the Mississippi River at E River Rd./N 1st St.
  • Downtown — E River Rd./N 1st St. to Hwy 371B; then, Hwy 371B to near Kingwood St.
Select PNG image to enlarge

Traffic impacts, work plans

Overall, motorists will encounter changes as they navigate through Brainerd. Detours will be necessary to work beneath the road and upgrade the Mississippi River bridge.

Brainerd is open

Access to those that live, work and visit areas along the project will be open and maintained at all times. However, expect changes:

  • Use of a side streets, alley or back/side entrances
  • Expect gravel surfaces or temporary entrances
  • Pedestrians will have sidewalk closures with detours (walk adjacent side of road)
  • Plan ahead and consider alternatives for you, your family, co-workers and businesses

Off-road work to occur at anytime along this project.

2026 work east to west

Spring-fall

Crews will work east to west on Hwy 210 from Pine Shores Rd. to Kingwood St. in 2026, which includes the east, mall and railyard segments.

Hwy 210 work areas in 2026
2026 work areas on Hwy 210/Washington St. between Kingwood St. and Pine Shores Rd. Select map image (PNG) to enlarge

Work highlights

  • Construct two new roundabouts
  • East segment will be resurfaced
  • Update city utilities and sidewalks

Impacts by segment

  • East - one lane each way
  • Mall - detour
  • Railyard - detour
  • Sidewalks - detour

The contractor will continue to work westward if time allows. All lanes and accesses on Hwy 210 will open over the 2026-2027 winter season.

2027 work west to east

Spring-fall

Crews will reconstruct west to east on Hwy 210 from west of Baxter Dr. to Kingwood St. in 2027, which includes the west, bridge and downtown segments.

Hwy 210 work areas in 2026
2027 work areas on Hwy 210/Washington St. Baxter Dr. to Kingwood St. Select map image (PNG) to enlarge

Work highlights

  • Resurface west segment
  • Reconstruct road surface
    • Includes signals, city underground utilities and sidewalks
  • Update the Mississippi River bridge, includes approaches, drainage structures and wider sidewalks

Impacts by segment

  • West - one lane each way
  • Bridge - detour
  • Downtown - detour
  • Sidewalks - detour

All lanes and accesses on Hwy 210 will open over the 2027-2028 winter season. Any remaining wrap-up work will occur in 2028.

Detour plans: 2026-2027

Work on this project will require segments of road closures with signed detours to work beneath the road and on the Hwy 210 bridge.

Year
Segment
Closed
Detour maps
2026-2027 All Hwy 210 segments

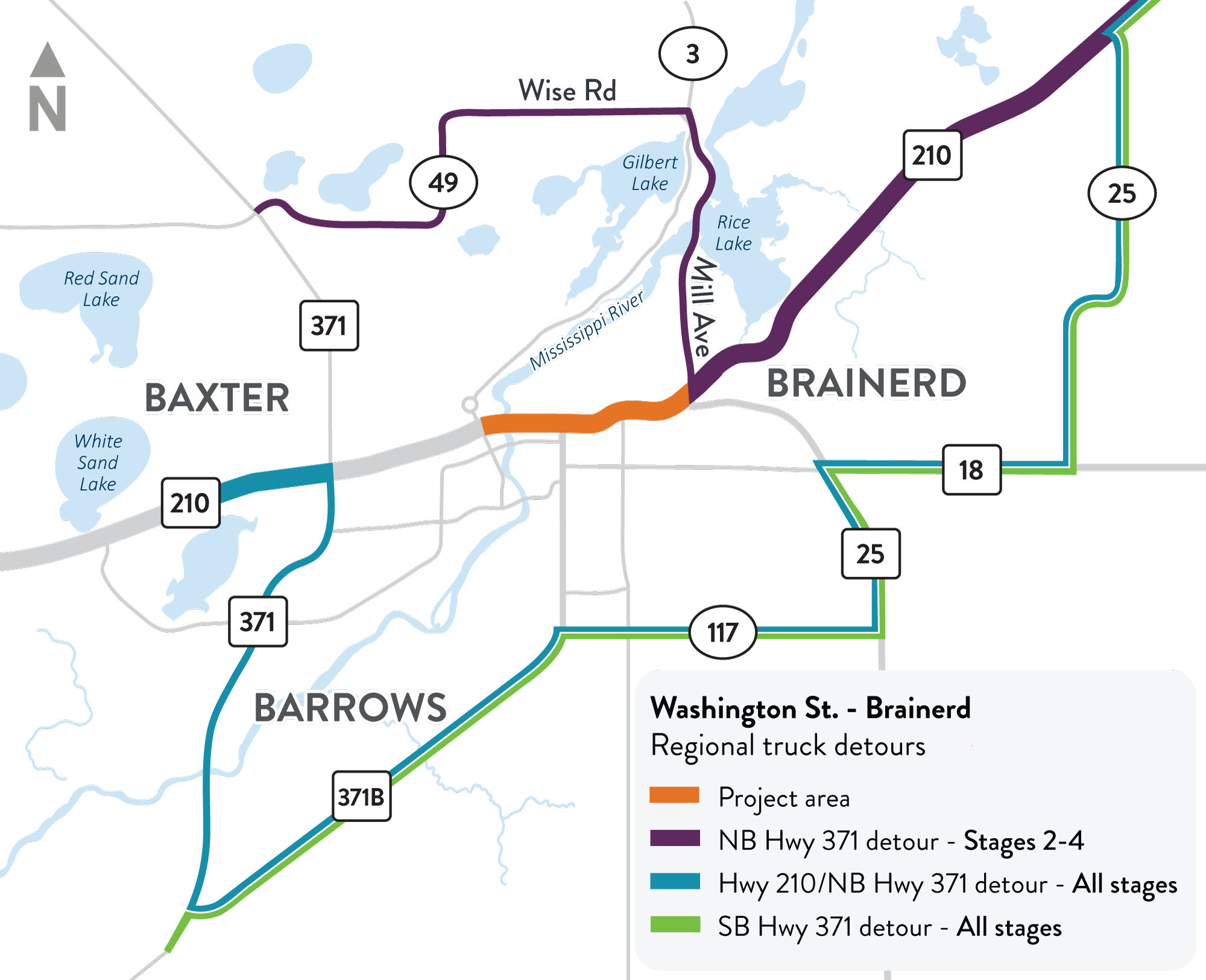

Regional truck detours: Avoid delays and use these signed through traffic/truck routes around the Brainerd work zone

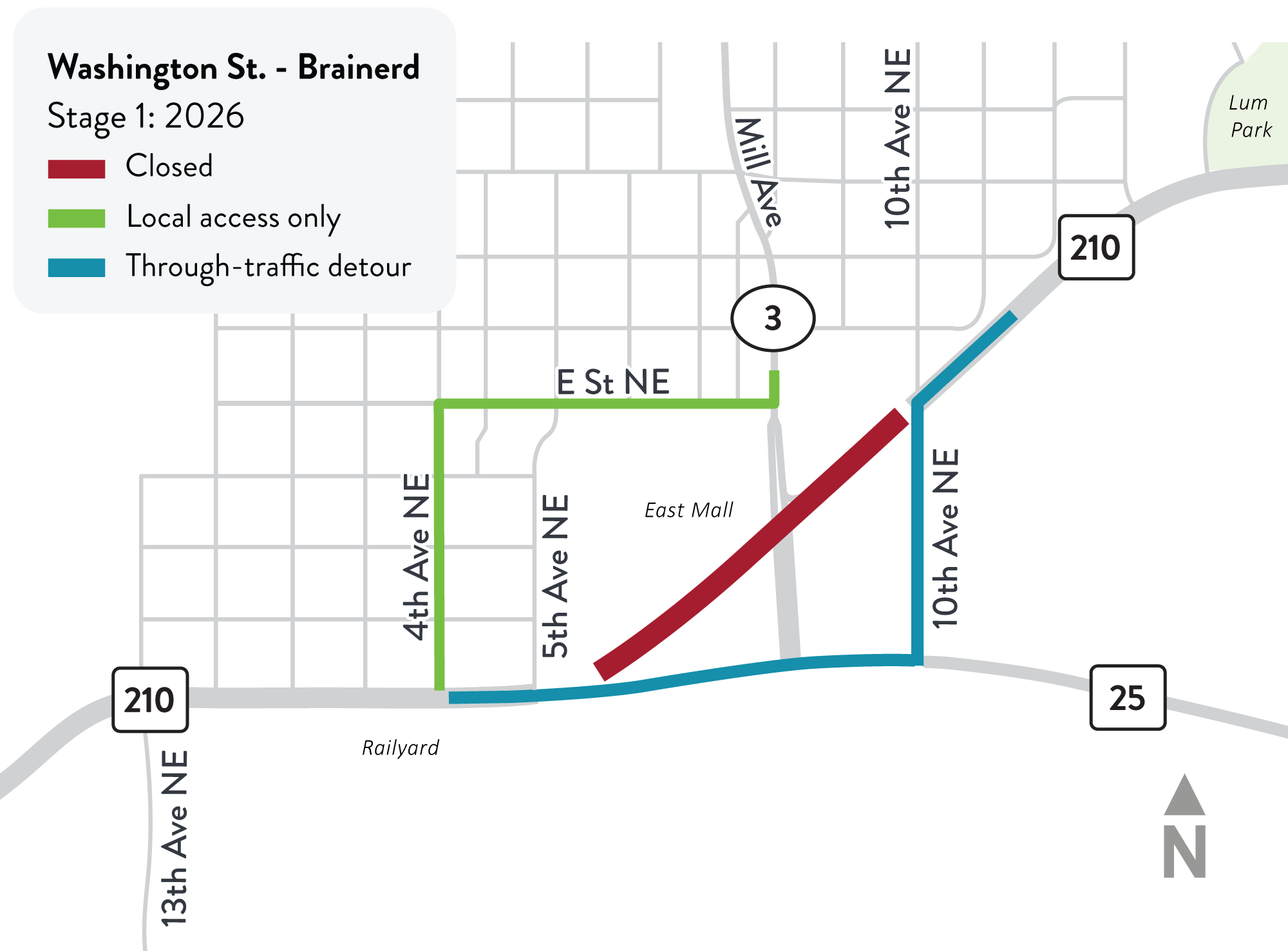

2026 Mall Hwy 210 closed 10th Ave. NE to 5th Ave. NE to construct roundabouts

Hwy 210 through traffic detour (PNG): 10th Ave. NE and Hwy 25

Local access only: 4th Ave. NE and E St. NE

2026 Mall Hwy 210 closed 10th Ave. NE to 5th Ave. NE to construct roundabouts

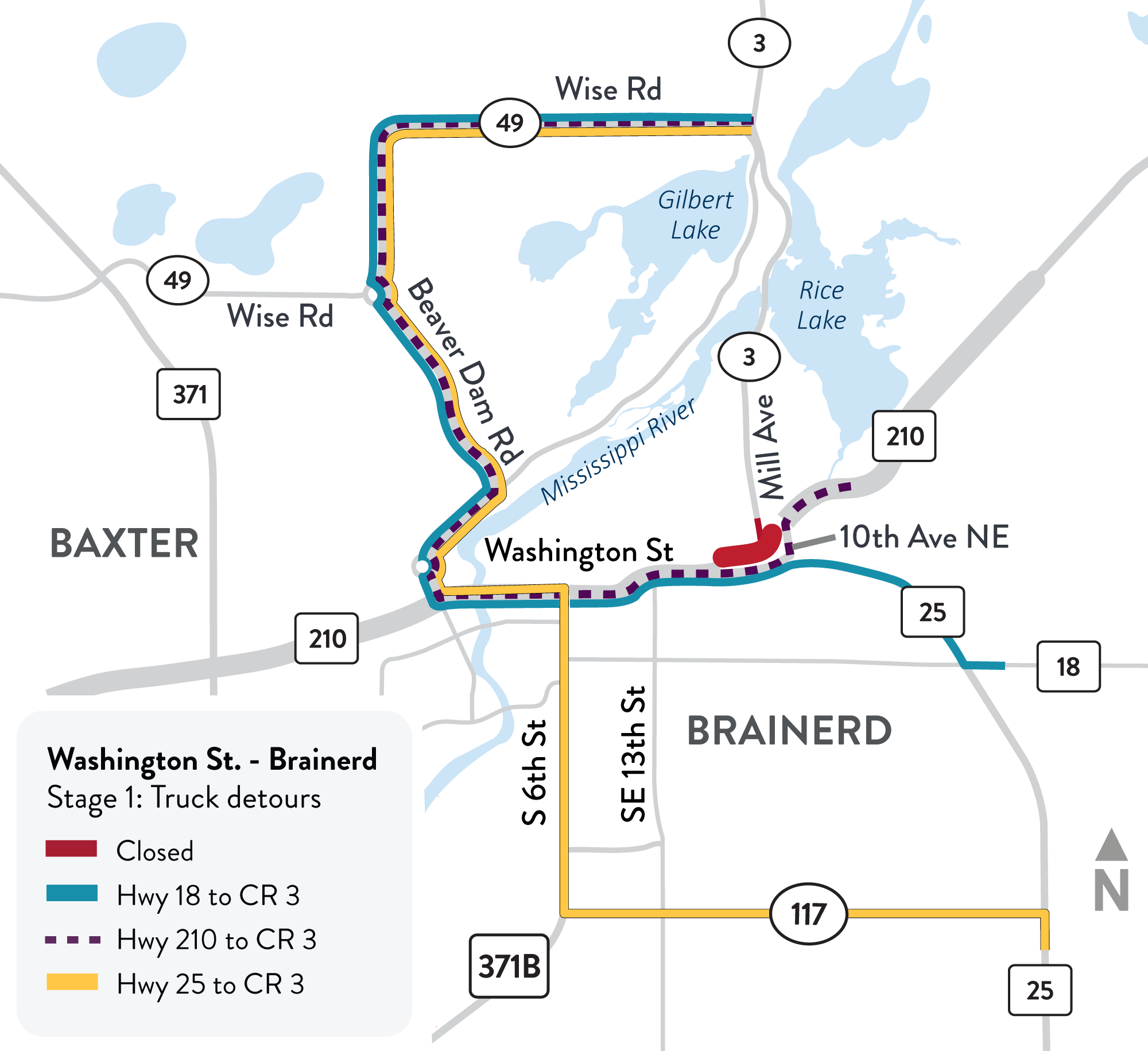

Mall segment truck detours (PNG):

  • Hwy 18 to CR 3: Hwy 25, Hwy 210, 4th St. NW, Beaver Dam Rd., CR 49
  • Hwy 210 to CR 3: 4th St. NW, Beaver Dam Rd., CR 49
  • Hwy 25 to CR 3: CR 117, Hwy 371B, Hwy 210, 4th St. NW, Beaver Dam Rd., CR 49
  • Note: Routes chosen to handle semi-trailer or longer vehicles in the area

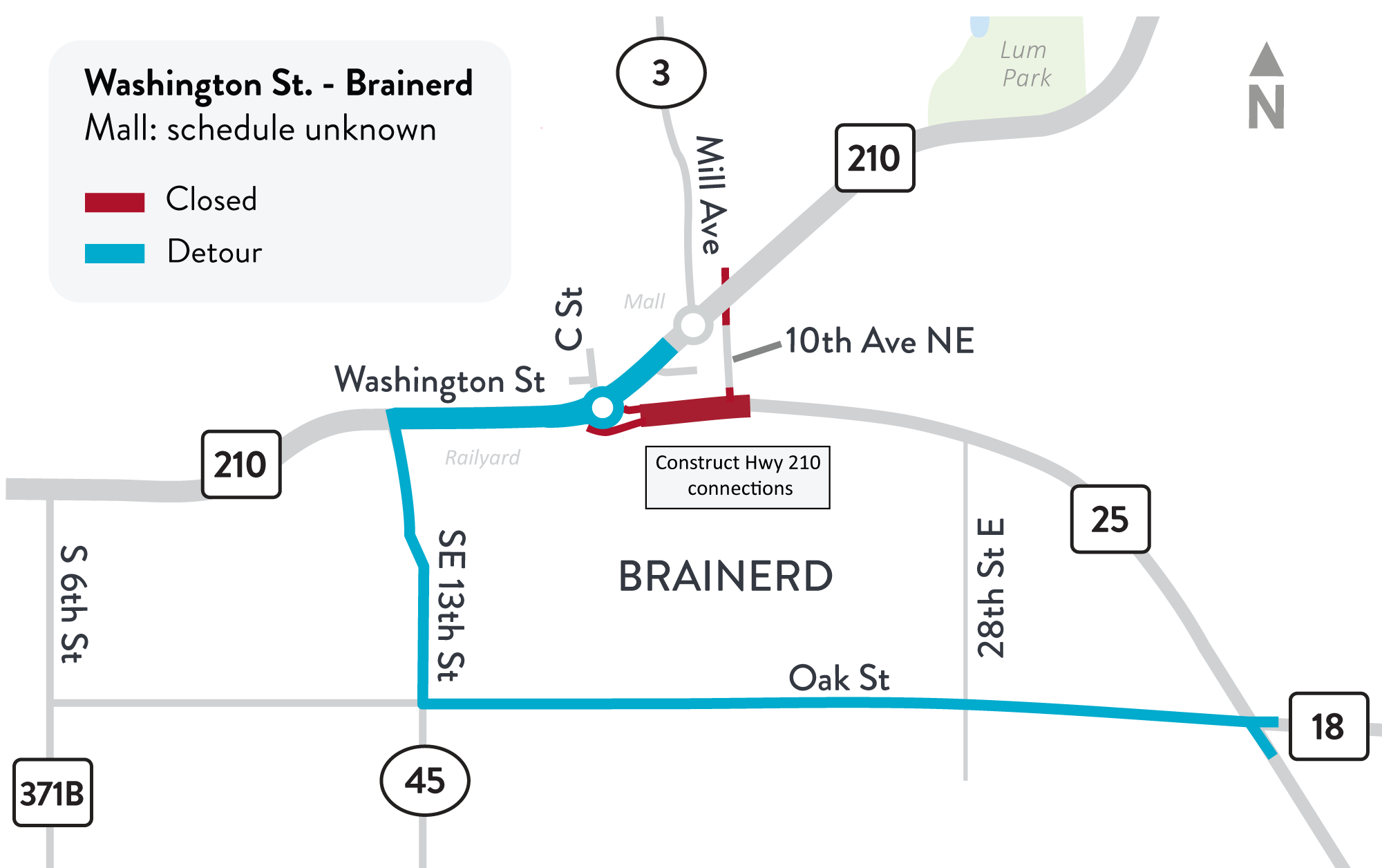

- Mall

Hwy 25 closed at Hwy 210 to east of 10th Ave. NE to reconstruct connections

Hwy 25 detour (PNG): Oak St., SE 13th St./CR 45 and Hwy 210

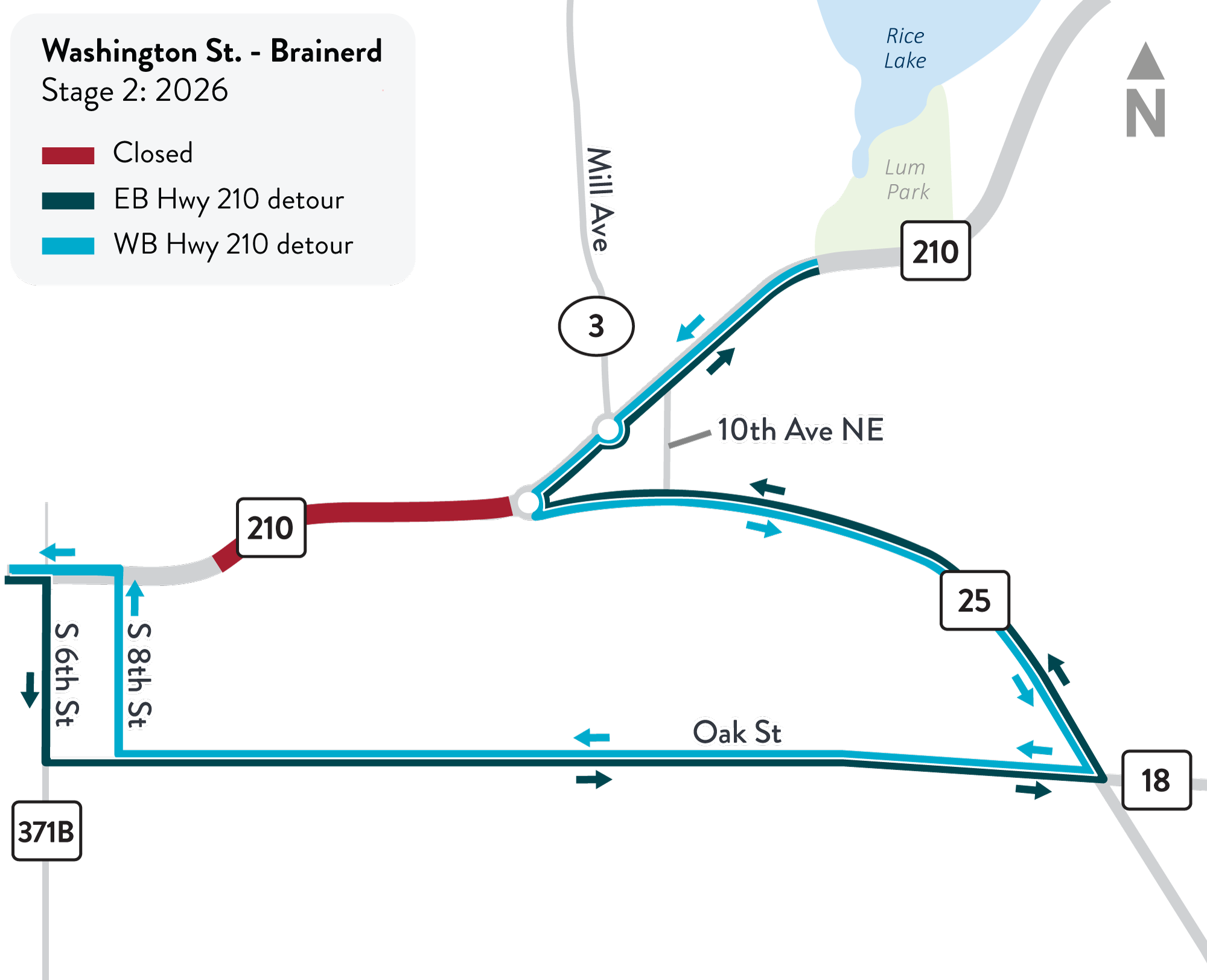

2026 Railyard Hwy 210 closed 5th St. NE to Kingwood St. to reconstruct road and install watermain

Hwy 210 railyard detour (PNG):

  • Eastbound: S 6th St./Hwy 371B, Oak St., Hwy 25 back to Hwy 210
  • Westbound: Hwy 25, Oak St., S 8th St back to Hwy 210

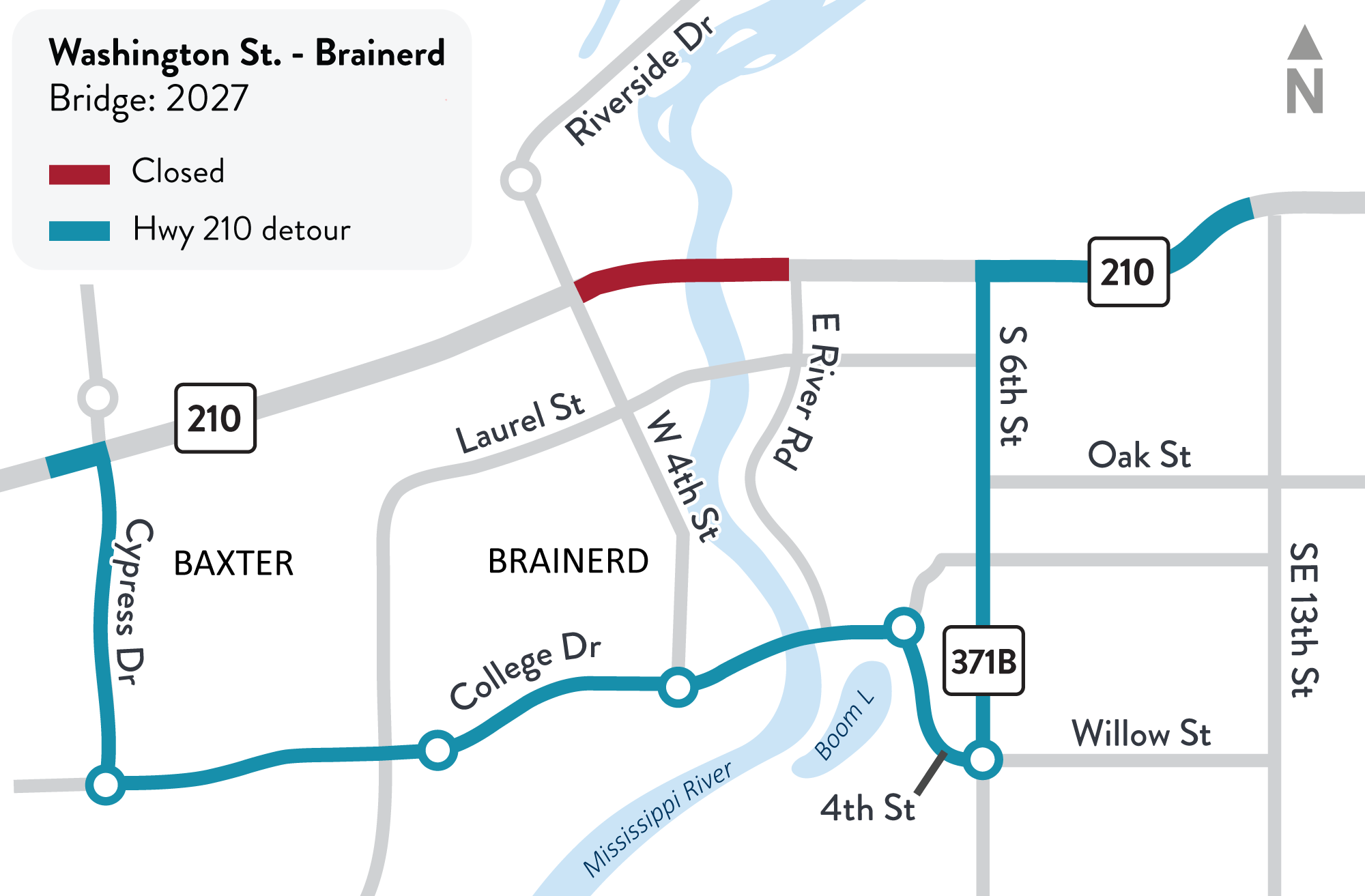

2027 Bridge Hwy 210 closed NW 4th St. to E River Rd. to reconstruct road, update underground drainage- includes Mississippi River bridge crossing

Hwy 210 through traffic detour (PNG): Cypress Dr., College Dr., 4th St. to Hwy 371B/S 6th St.

Note: Laurel St. bridge open to local traffic only, includes emergency services

2027 Downtown

Hwy 210 closed E River Rd. to S 6th St. to reconstruct road

Hwy 210 through traffic detour (PNG): Cypress Dr., College Dr., 4th St. to Hwy 371B/S 6th St.

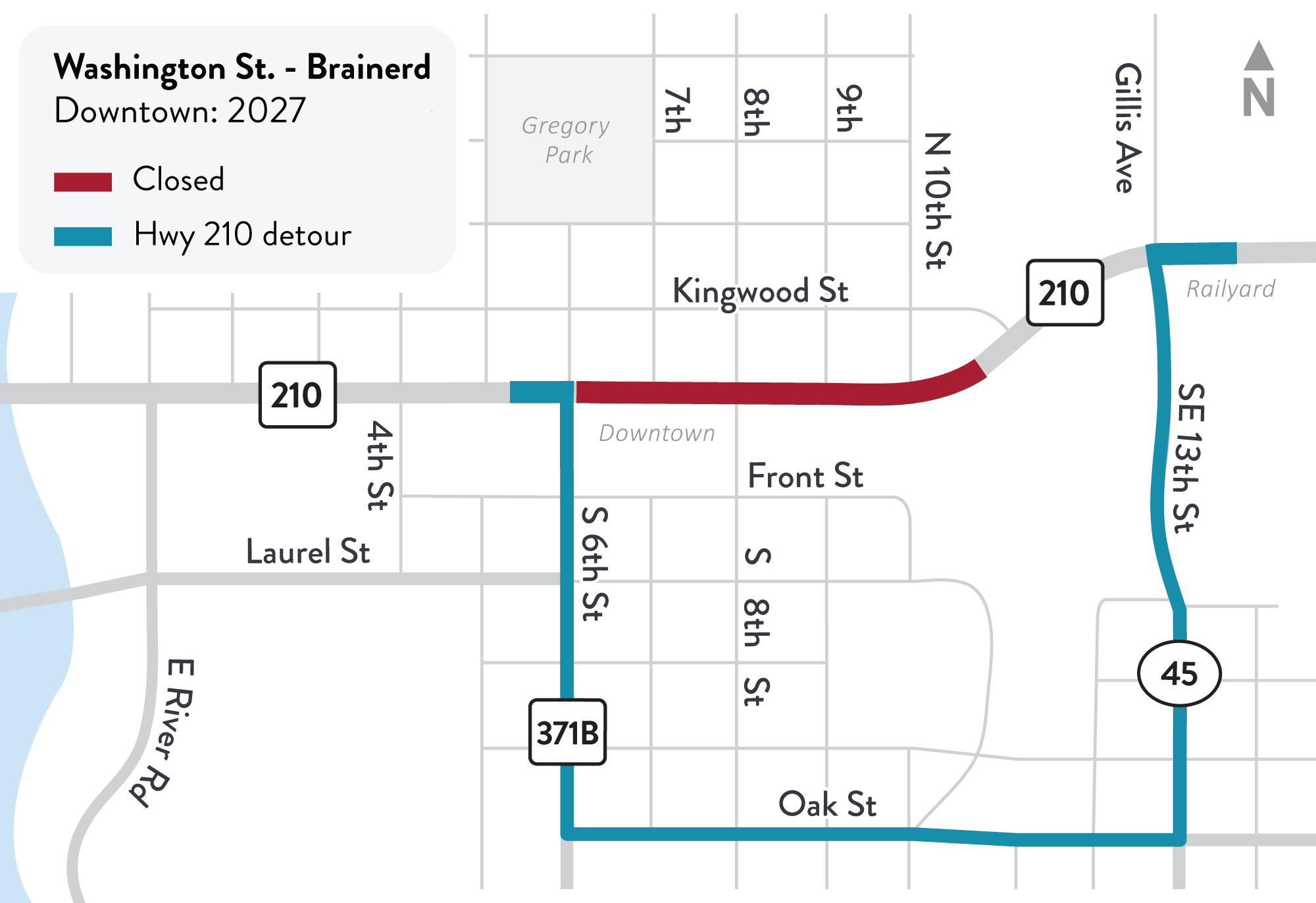

2027 Downtown Hwy 210 closed between S 6th St./Hwy 371B and Kingwood St. to reconstruct road Hwy 210 through traffic detour (PNG): Hwy 371B, S 6th St., Oak St. and SE 13th St./CR 45

**All information is tentative and subject to change until contractor is on board. Materials, weather and unexpected items found beneath the road can also change schedules. March 2025
