I-90/Hwy 52 interchange reconstruction

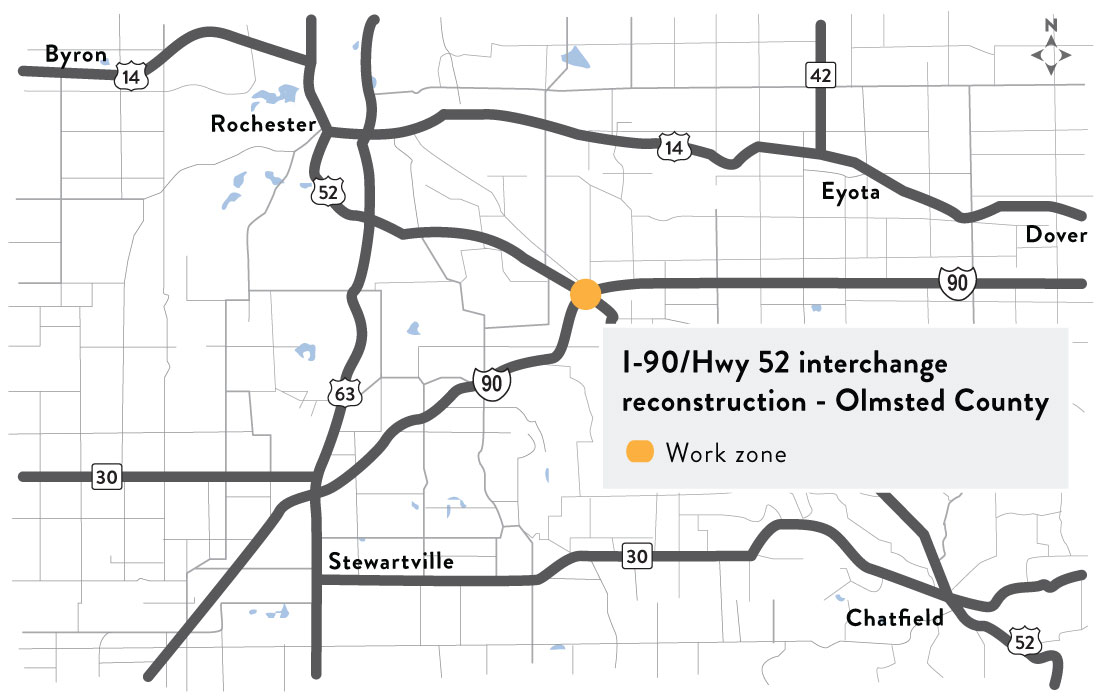

Olmsted County

Sign up for project email updates

About this project

Summary of work

I-90/Hwy 52 interchange project map
I-90/Hwy 52 interchange project map

Construction is scheduled 2024-2026 to make changes to the I-90/Hwy 52 interchange to improve safety and reduce delays.

  • 2024: Constructed temporary crossovers and begin new ramps and loops
  • 2025 (April to November): Construct new eastbound I-90 bridge, flyover bridge over Hwy 52 and portion of new ramps and loop
  • 2026: Construct new westbound I-90 bridge and remaining portion of new ramps and loops

Improvements

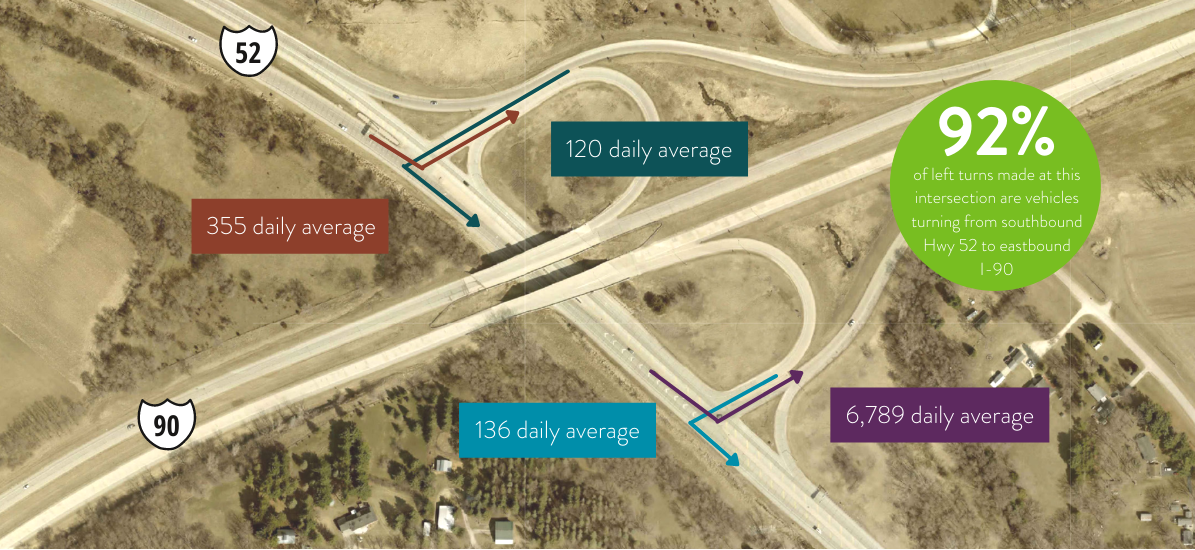

A new feature, a flyover ramp, for southbound Hwy 52 to eastbound I-90, will solve several problems:

New ramps will reduce the run-off-the-road crashes:

  • Changing the angles will allow for better, more controlled entrance/exit
  • Lengthened accelerations lanes will also improve conditions

The bridge replacements will allow for:

  • Relocation of the bridge piers that block the view of on-coming traffic
  • Improved bridges that will last another 60 years or more

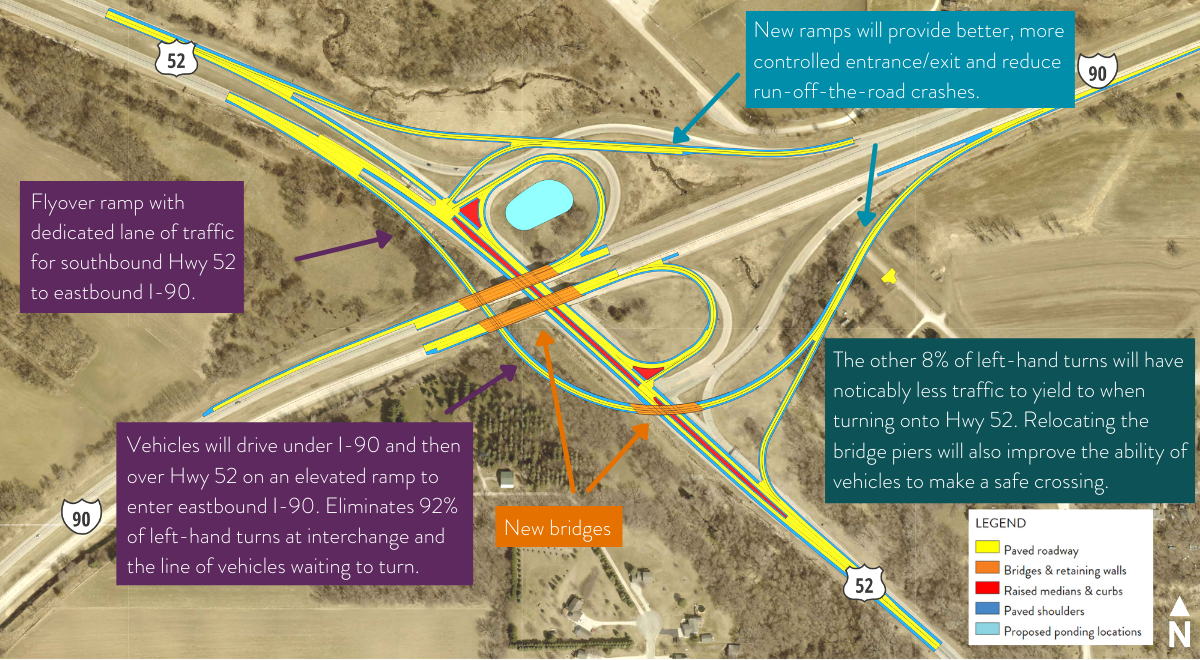

Proposed changes at interchange
Improvements at I-90 and Hwy 52 interchange

Traffic impacts

Check www.511mn.org or the free mobile app to see current traffic impacts. The below dates are subject to change.

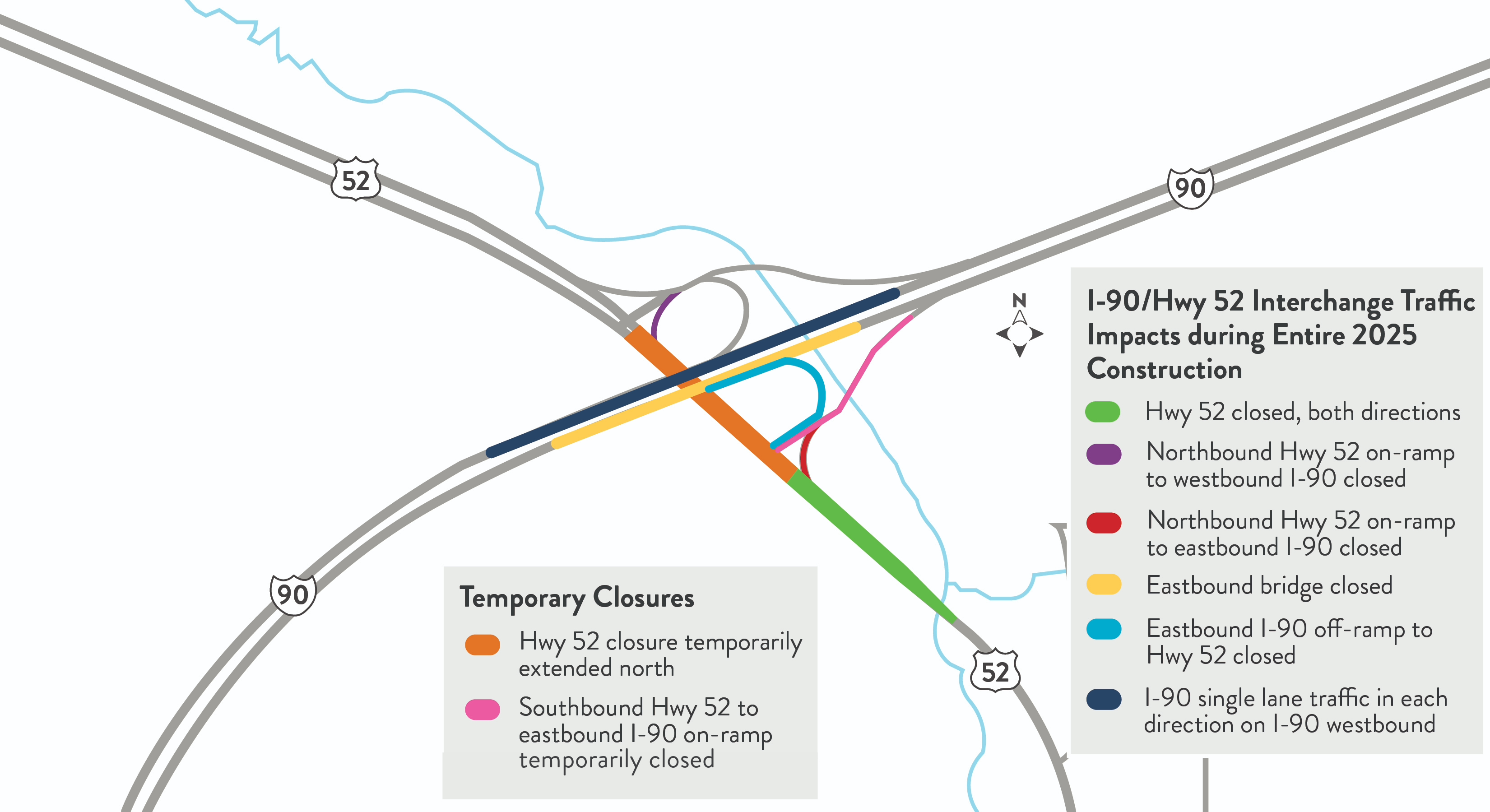

Closures during entire 2025 construction:

  • I-90 westbound and eastbound traffic will travel in single lanes adjacent to each other on I-90 westbound in the project area (scheduled April 7 through fall) while the new I-90 eastbound bridge is being constructed
  • Eastbound I-90 off-ramp to Hwy 52 closed (scheduled April 7 through fall)

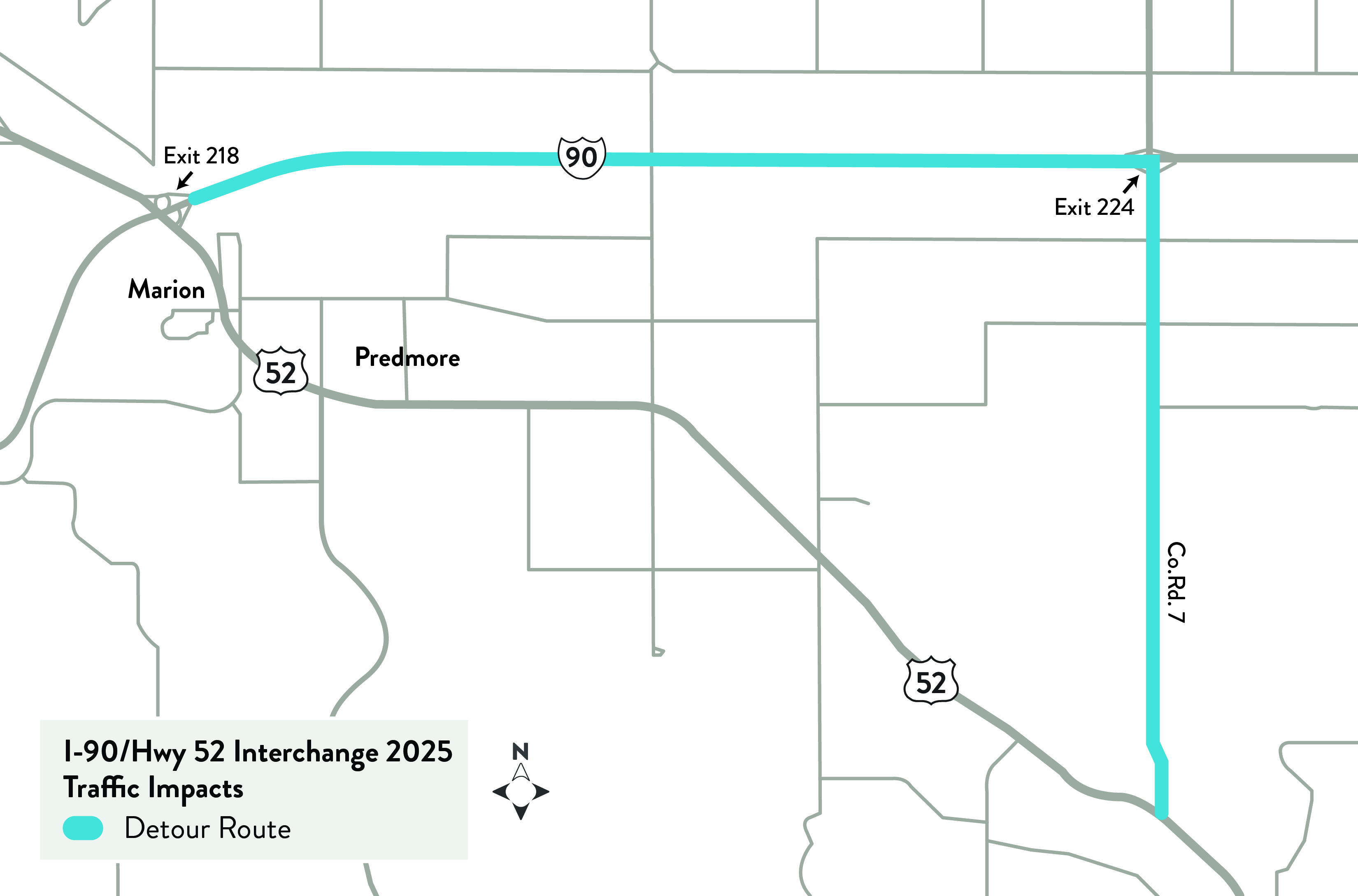

    • Continue on eastbound I-90 and take Exit 224 (Eyota exit)
      • To go south on Hwy 52, go south on Olmsted Co. Rd. 7 which intersects with Hwy 52
      • To go north on Hwy 52, turn left over bridge and exit onto westbound I-90, take ramp to Hwy 52 (Exit 218)
  • Hwy 52 closed, south of eastbound I-90 on-ramp (scheduled April 8 through fall)

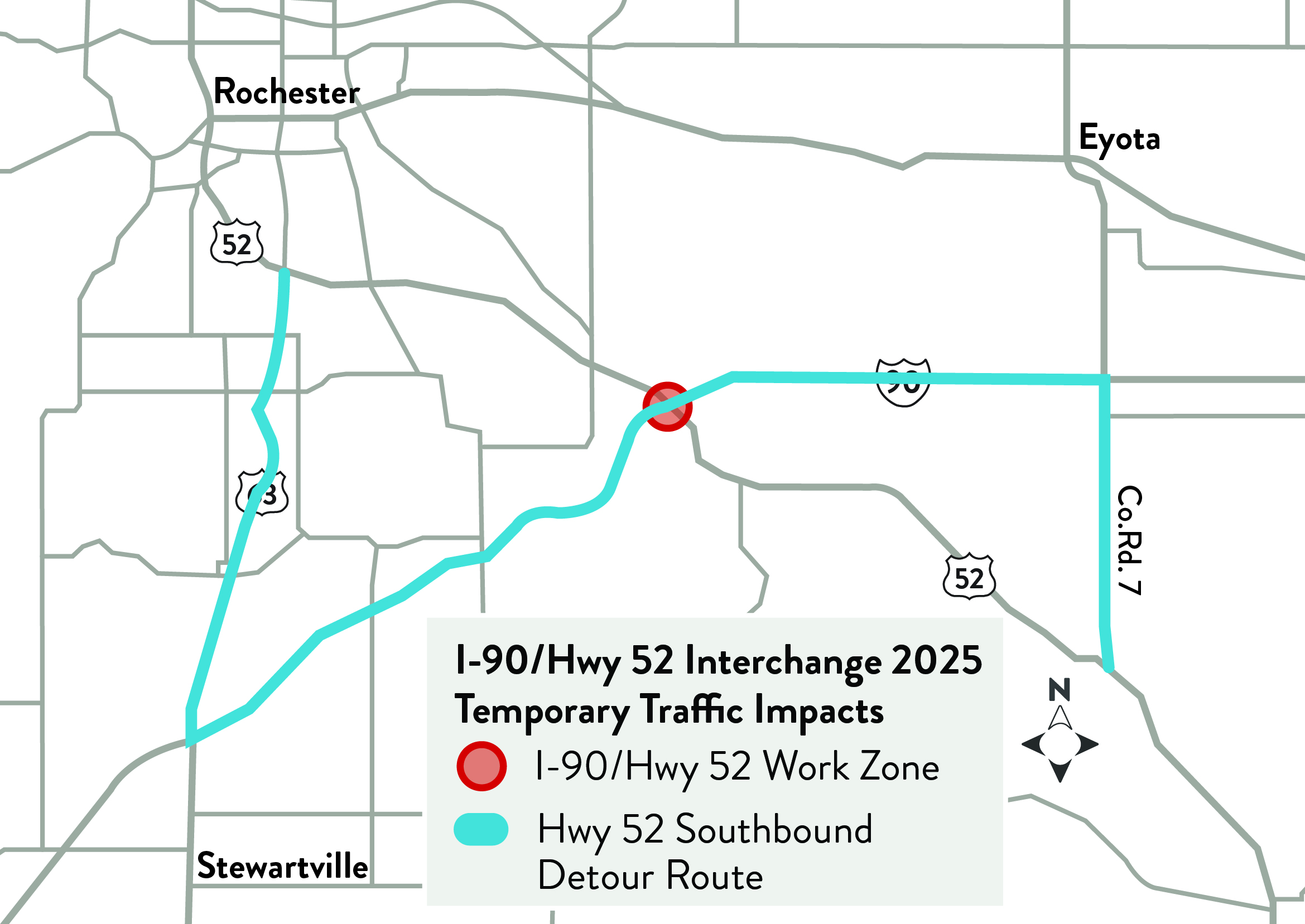

    • To travel north on Hwy 52 (from Chatfield), go north on Olmsted Co. Rd. 7 and exit onto westbound I-90, take ramp to Hwy 52 (Exit 218)
    • To travel south on Hwy 52 (from Rochester), exit to I-90 eastbound, take Exit 224 (Eyota exit), take a right and go south on Olmsted Co. Rd. 7 which intersects with Hwy 52
  • Northbound Hwy 52 on-ramp to eastbound I-90 closed (scheduled April 8 through fall)
    • Go north on Olmsted Co. Rd. 7 and exit onto eastbound I-90
  • Northbound Hwy 52 to westbound I-90 on-ramp closed (scheduled April 8 through fall)
    • Go north on Olmsted Co. Rd. 7 and exit onto westbound I-90

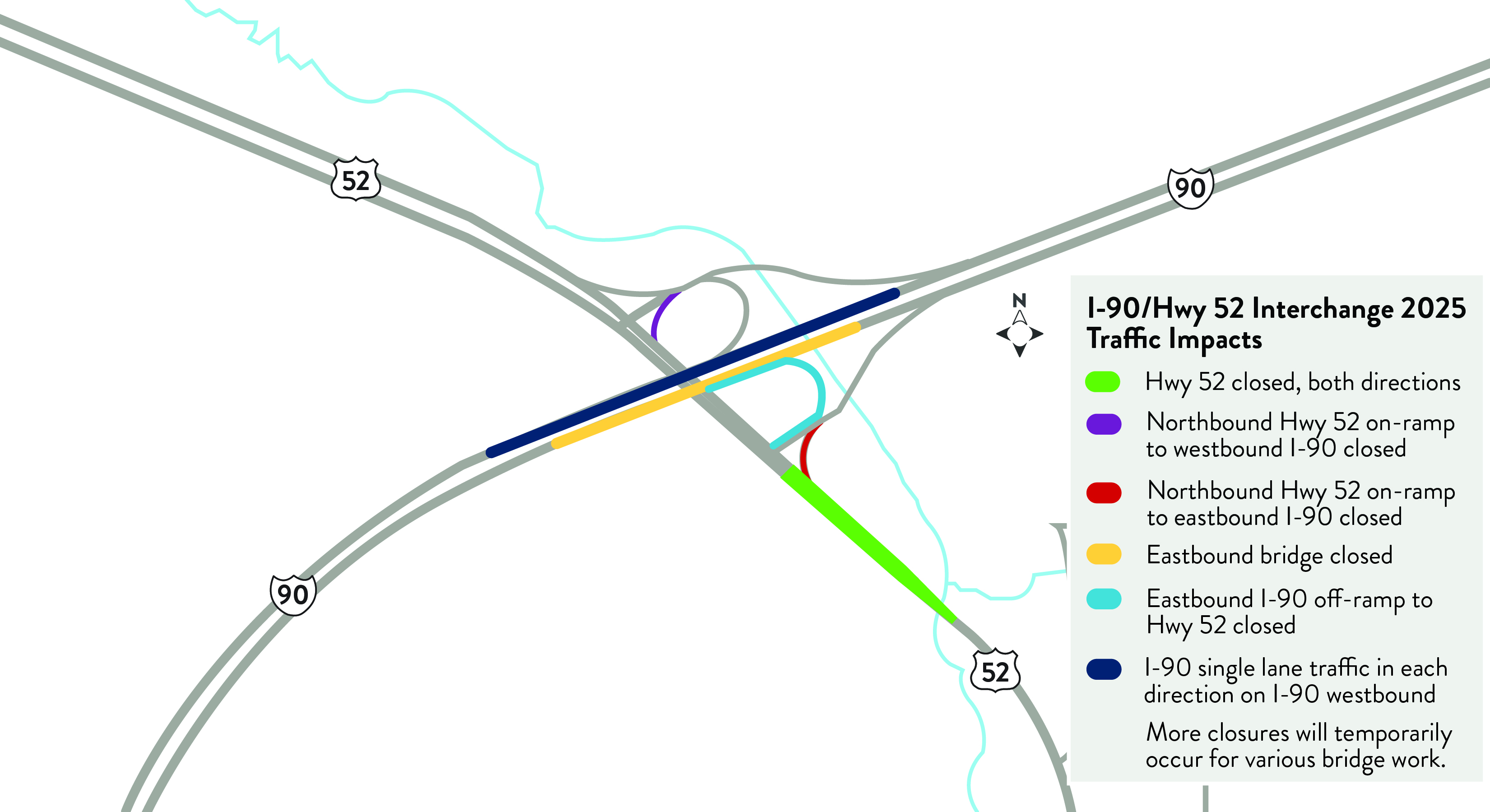

Temporary closures during 2025 construction:

  • During eastbound I-90 bridge removal (scheduled April 8-12): Hwy 52 closed south of westlbound I-90 on-ramp to south of eastbound I-90 on-ramp, and the Hwy 52 on-ramp to I-90 eastbound closed
  • Five separate one-day closures during the construction of the new eastbound I-90 bridge for the placement and removal of the falsework and for the bridge deck pour

Open during 2025 construction:

  • Westbound I-90 off-ramp to northbound Hwy 52
  • Southbound Hwy 52 to westbound I-90 on-ramp
  • Southbound Hwy 52 to eastbound I-90 on-ramp (with the exception of temporary closures)
